Construction: Stage 1
In the 2023-24 ACT Budget, the ACT Government matched the $5 million committed by the Australian Government for detailed design and construction of the first stage of the route. This includes segments one to four identified in the preliminary stage of design, which includes the connections between the City and Braddon from Cooyong Street, along Torrens and Ijong streets and along Angas Street to Majura Avenue.

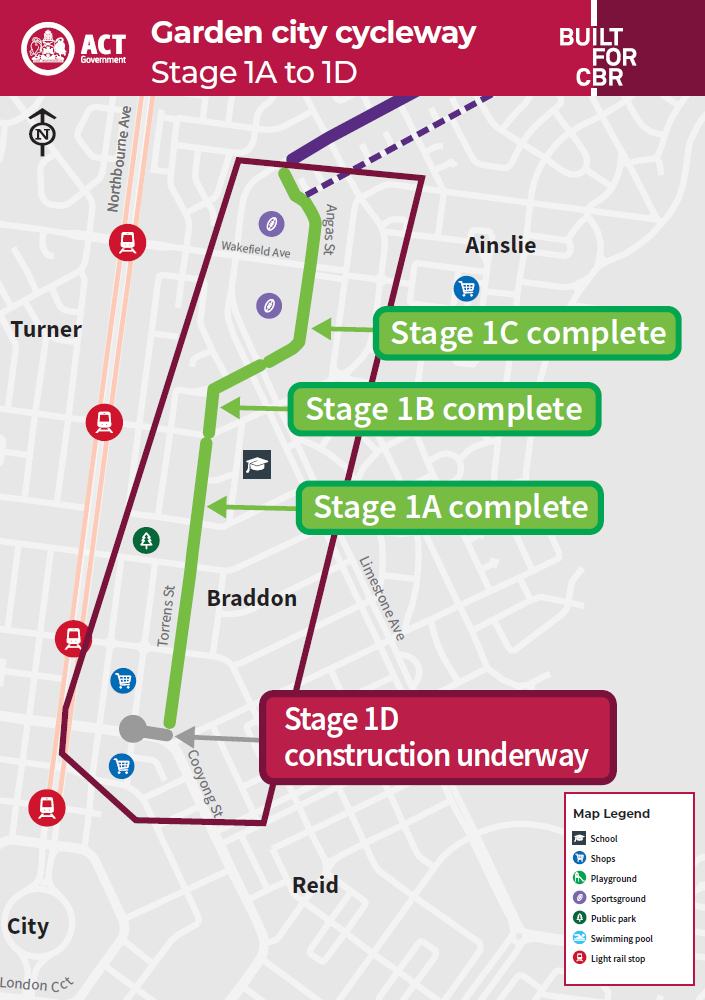

Stage 1 has been split as follows:
A. Torrens Street between Cooyong Street and Ipima Street
B. Torrens Street from Ipima Street to Ijong Street and along Ijong Street to Limestone Avenue
C. Angas Street between Limestone Avenue and Majura Avenue
D. Cooyong Street.
1A: Torrens Street between Cooyong Street and Ipima Street
This is the first part of the route to be constructed. It includes both the path and new raised zebra crossings.
A new 4 metre wide concrete walking and cycling path will be constructed in the eastern verge of Torrens Street, from Cooyong Street to Henty Street and a new 3 metre wide path will continue from Henty Street to Ijong Street in Braddon.
The existing concrete path will be removed and replaced. Where the cycleway crosses driveways, sections of the driveway will be treated with coloured pavement and line marking to alert users to the driveway crossing point.
In addition, 6 new raised concrete zebra crossings will be constructed along the cycleway at the crossing points on Torrens Street (near Cooyong Street), Elouera Street, Girrahween Street, Henty Street, Helemon Street and Ipima Street. You can take a look at the detailed drawing (PDF 3.6 MB).
1B: Torrens Street from Ipima Street to Ijong Street and along Ijong Street to Limestone Avenue
This is the second part of the cycleway to be constructed. It includes both the path and traffic lights at the Limestone Avenue intersection.
A new 3 metre wide asphalt walking and cycling path will be constructed in the eastern verge of Torrens Street and Ijong Street. The existing concrete path will be removed and replaced by the new path. Where the path crosses driveways, sections of the driveway will be treated with coloured pavement marking and line marking used to alert of the driveway crossing point. In addition, new traffic lights will be installed at the Limestone Avenue/Ijong Street/Angas Street intersection. You can take a look at the detailed drawing (PDF 1.8 MB)
1C: Angas Street from Limestone Avenue to Majura Avenue
This is the third part of the cycleway to be constructed. It includes both the path and 4 raised concrete zebra crossings.
A new 3 metre wide asphalt walking and cycling path will be constructed in the eastern verge at the start of Angas Street then crossing to the western verge and continuing to Majura Avenue. The existing concrete path will be removed and replaced by the new path. Where the path crosses driveways, sections of the driveway will be treated with coloured pavement marking and line marking used to alert of the driveway crossing point. In addition, four raised concrete zebra crossings will be constructed along the cycleway at the crossing points on Angas Street, Wakefield Avenue and at the Ainslie district playing fields carpark entry and exit. You can take a look at the detailed drawing (PDF 7.1 MB).
